What Is the Process for Remodeling a Commercial Space in Puerto Vallarta? A Complete Guide for Business Owners

  • Writer: Manuel Coronel
    Manuel Coronel
  • 2 days ago
  • 4 min read

A Complete Guide for Business Owners


If you’re wondering what is the process for remodeling a commercial space in Puerto Vallarta, you’re not alone. With tourism booming and businesses expanding, many entrepreneurs are upgrading retail stores, restaurants, and offices to stay competitive.

Puerto Vallarta offers incredible opportunities—but remodeling here involves permits, regulations, and local expertise that differ from other regions.


Behind every successful restaurant, boutique, or wellness studio in Vallarta lies a carefully orchestrated process: permits aligned with local authorities, materials selected for humidity and salt air, and spatial strategies that respond to both foot traffic and lifestyle patterns.


If you're planning to remodel a commercial property, understanding this process early will save you time, reduce risk, and ultimately elevate your business's value.


Why Puerto Vallarta is a Hotspot for Commercial

  • Growing tourism economy

  • Expanding restaurant and hospitality sector

  • High ROI on upgraded commercial spaces

  • Increasing demand for modern design


Key Considerations Before Starting

Before diving in, consider:

  • Location zoning regulations

  • Budget vs expected ROI

  • Timeline constraints

  • Local construction laws



What is the process for remodeling a commercial space in Puerto Vallarta?


Step-by-Step Process for Remodeling a Commercial Space in Puerto Vallarta


Step 1: Define Project Scope and Goals


Start with a clear vision. Ask:

  • What type of business are you opening?

  • What experience do you want to create?

  • Who is your target customer?

  • What is your budget?


Business Needs & ROI

Factor

Example

Purpose

Restaurant, retail, office

Target Audience

Tourists vs locals

ROI Goal

Increase revenue by 20%

Design Style

Modern, coastal, luxury


This phase translates your business model into spatial decisions:

  • Circulation flows (how people move through the space)

  • Visibility and storefront presence

  • Functional zoning (service, prep, storage, customer areas)


💡 A restaurant in Versalles behaves differently than a boutique in Zona Romántica. Context defines strategy.


Step 2: Hire an Architect or Design Firm


Hiring a local architect or construction firm is essential.


Importance of Local Expertise

Local professionals understand:

  • Municipal codes

  • Permit processes

  • Climate considerations (humidity, coastal wear)


👉 Recommended resource:https://www.puertovallarta.gob.mx (official municipal site for permits)



Step 3: Site Analysis and Existing Conditions


Every remodel starts with uncovering reality.


An architectural team evaluates:

  • Structural condition of the property

  • Existing electrical and plumbing systems

  • Ceiling heights and natural ventilation

  • Access points and code compliance


In Puerto Vallarta, many commercial spaces are adapted from residential structures, meaning:

  • Electrical systems may lack proper grounding

  • Drainage and ventilation may not meet commercial standards


This phase often determines the true scope—and cost—of your project.



Step 4: Concept Design and Budget Planning

Your architect creates:

  • Layout plans

  • 3D renderings

  • Initial cost estimates


Budget Planning Table

Category

Estimated % of Budget

Design & Planning /Professional fees (architecture, engineering, Branding and signage)

15–20%

Permits & Legal

5–10%

Construction

60–70%

Finishes & Furniture

15–20%



Typical Cost Ranges (Puerto Vallarta & Riviera Nayarit)

Level of Finish

Estimated Cost (MXN/m²)

Description

Basic Fit-Out

$12,000 – $18,000

Functional upgrades, minimal design

Mid-Range

$18,000 – $30,000

Balanced design + durable materials

High-End

$30,000 – $50,000+

Custom design, premium finishes

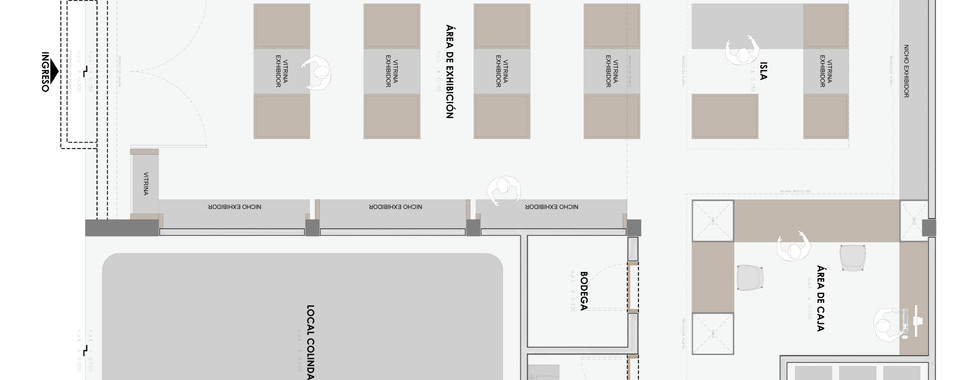

COMMERCIAL REMODELING CASE STUDY: SILVER JEWELRY



Step 5: Design Development and Material Selection


This is where the space begins to take shape—but in Puerto Vallarta, design is inseparable from climate.


Why Durable and Weather-Resistant Materials Matter

The coastal environment introduces:

  • High humidity

  • Salt air corrosion

  • Intense sun exposure

  • Heavy foot traffic (especially in tourist zones)


Recommended Material Strategies

  • Floors: Porcelain tile, polished concrete, natural stone (non-slip finishes)

  • Walls: Lime plaster, microcement, treated wood panels

  • Furniture: Marine-grade fabrics, sealed woods, powder-coated metals

  • Hardware: Stainless steel or anti-corrosion finishes

💡 A beautiful space in Vallarta is one that ages gracefully—not one that fights the environment.



Step 6: Permits and Legal Requirements


This is often the most underestimated phase—and the one that can delay projects significantly.


Key Permits for Commercial Remodeling

Permit

Authority

Purpose

Timeline

Land Use (Uso de Suelo)

Municipio

Confirms business activity is allowed

1–3 weeks

Construction License

Municipio

Required for any physical work

2–6 weeks

Civil Protection Approval

Protección Civil

Safety compliance

2–4 weeks

Environmental (if applicable)

SEMARNAT

Required for certain locations

4–12 weeks

⚠️ In coastal zones (Punta Mita, Bucerías, La Cruz), additional federal regulations may apply, especially near the ZOFEMAT strip.



Step 7: Construction Phase


Once permits are secured, construction begins—but the quality of execution defines the final result.


A well-managed project includes:

  • Detailed construction drawings

  • Contractor coordination

  • Timeline control

  • Budget tracking

  • On-site supervision


In commercial projects, time is money. Delays directly impact opening dates and revenue.

Step 8: Branding, Signage, and Final Touches


A commercial space is not complete without identity.


This phase includes:

  • Exterior signage and visibility strategy

  • Interior graphics and wayfinding

  • Lighting atmosphere

  • Furniture and styling


The goal is coherence—your space should communicate your brand without needing explanation.


Step 9: Inspections and Final Approval

Final steps include:

  • Government inspections

  • Safety approvals

  • Occupancy permit


Timeline Breakdown for Commercial Remodeling

Phase

Duration

Planning & Design

4–8 weeks

Permits

4–12 weeks

Construction

8–20 weeks

Final Approvals

2–4 weeks


What Does an Architecture Studio Analyze in Commercial Remodel Projects?


A professional studio doesn’t just design—it anticipates.


Key Areas of Analysis:

  • Customer Experience: How space influences behavior

  • Operational Efficiency: Staff flow, service speed, logistics

  • Durability: Materials that withstand climate + use

  • Compliance: Ensuring all regulations are met

  • Return on Investment: Design decisions that increase long-term value


💡 Good design attracts. Smart design performs.


Common Mistakes to Avoid

  • Starting construction without permits

  • Underestimating electrical and plumbing upgrades

  • Choosing materials based on aesthetics alone

  • Ignoring climate impact

  • Not hiring professional design and project management


Conclusion: Building a Space That Lasts

Remodeling a commercial space in Puerto Vallarta is both an opportunity and a responsibility.

Done right, it becomes more than a place of business—an experience, a brand, and an asset that grows in value over time.



FAQ — Commercial Remodeling in Puerto Vallarta


Do I need permits to remodel a commercial space in Puerto Vallarta?

Yes. Most projects require a construction license, land use authorization, and civil protection approval.


How long does the permitting process take?

Typically between 2 and 8 weeks, depending on project complexity and location.


How much does it cost to remodel a commercial space?

Costs range from $12,000 to $50,000+ MXN per square meter, depending on finishes and scope.


What materials are best for Puerto Vallarta’s climate?

Porcelain tile, natural stone, treated wood, and corrosion-resistant metals are recommended.


Can I start construction without permits?

No. Doing so can result in fines, shutdowns, or legal complications.
